International Journal of Computational Intelligence Systems

Volume 14, Issue 1, 2021, Pages 935 - 945

A MCDM Method with Linguistic Variables and Intuitionistic Fuzzy Numbers to Evaluate Product Development Projects

Authors
Chen-Tung Chen1, *, Wei-Zhan Hung2
1Department of Information Management, National United University, Miaoli, 36003, Taiwan
2Department of digital business management, Kao Yuan University, Kaohsiung City, 821 Taiwan
*Corresponding author. Email: ctchen@nuu.edu.tw
Corresponding Author
Chen-Tung Chen
Received 28 February 2020, Accepted 4 February 2021, Available Online 3 March 2021.
DOI
10.2991/ijcis.d.210222.003How to use a DOI?
Keywords
Product development projects (PDP); Linguistic variable; Intuitionistic fuzzy number; Multiple criteria decision-making (MCDM)
Abstract

The high-tech consumer goods market is a rapidly changing environment. Project evaluation and selection play important roles in an organization to increase its competitive advantages successfully. When handling new product project decision problems, it is important to collect information to make the right decision at the initial stage of product development. Past research found that managers usually only evaluate product development projects (PDP) based on a company's own resources. However, competitors can generate similar products to compete in the market. In this way, the process of PDP evaluation and selection should consider internal and external factors. In other words, it is a multiple-criteria decision-making (MCDM) problem. In addition, uncertainty and complex project evaluations are usually involved in dealing with MCDM problems. Therefore, we propose a new MCDM method by combining linguistic variables with intuitionistic fuzzy numbers (IFNs) to analyze the performance of PDPs. The proposed method is then implemented to evaluate a new kind of smartphone in order to fit with 5th generation mobile networks (5G). Finally, the conclusions and future research direction are discussed.

Copyright
© 2021 The Authors. Published by Atlantis Press B.V.
Open Access
This is an open access article distributed under the CC BY-NC 4.0 license (http://creativecommons.org/licenses/by-nc/4.0/).

1. INTRODUCTION

Project evaluation and selection play an important role in an organization to successfully increase its competitive advantages. When handling new product project decision problems, it is important to collect information to make the right decision at the initial stage of product development. According to resource-based theory (RBT), enterprises striving for sustainable development should possess heterogeneous resources with characteristics that are valuable, rare, irreplaceable, and nonreplicated [1,2]. However, it is difficult to generate or acquire heterogeneous resources for each enterprise in a competitive market. In this way, enterprises can easily develop novel products that are similar to other enterprises because the products are easily imitated by other enterprises. Therefore, enterprise should predict the profitability of a product carefully by considering the imitation of other competitors. The profit of a novel product can be separated into three time periods: the monopoly period, the competitive period, and the obsolete period [3]. In the monopoly period, the novel product will have large sales numbers because other competitors have not generated a similar product. In the competitive period, the profit of the new product will decrease because other competitors have developed similar products. In the obsolete period, new products will have been developed by competitors and the enterprise should consider to stop manufacturing the original product (Figure 1).

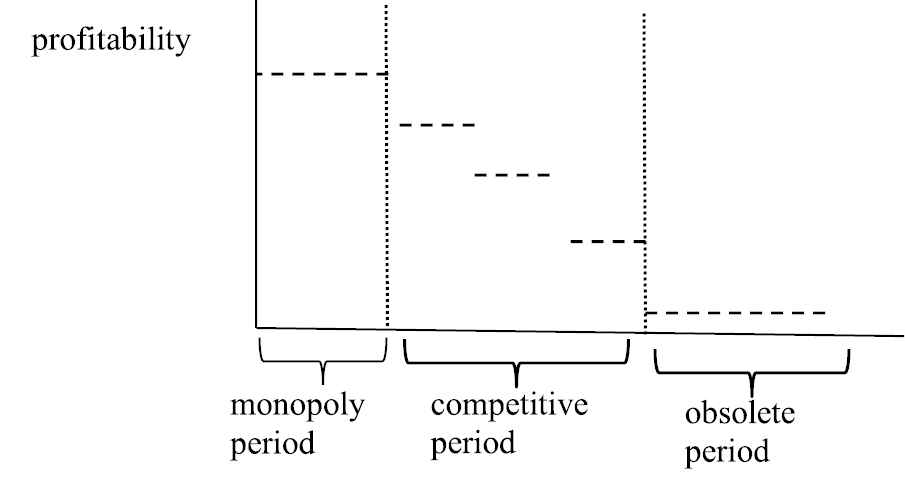

Figure 1

Profitability of product in each period.

Therefore, when an enterprise develops a novel product, it should not only consider its resources in order to develop the product successfully, but also consider the overall profit among all three periods by taking care of the imitation of competitors. In fact, many internal and external factors will influence the evaluation and selection of product development projects (PDP). In this way, PDP decisions can be regarded as a multiple-criteria decision-making (MCDM) problem. The main goal of this paper was to build a framework to analyze the performance of PDP in order to help enterprises decide on the suitable PDP to implement.

In general, vague, imprecise, or insufficient information always exists in a business environment [4]. Uncertainty and complex project evaluations are usually involved in dealing with PDP evaluation and selection problems. Faced with this decision environment, experts cannot always use crisp values to express their opinions. Intuitionistic fuzzy sets (IFS) are useful tools to cope with the uncertainty information, because experts can flexibly express their opinions according to the membership degree, nonmembership degree, and in-determine degree [5]. In decision science fields, the projection method has been used as an effective measurement tool to calculate the similarity degree between alternatives [6]. Up to now, the projection tool has been applied in various decision-making problems, such as partner selection [7], personnel selection [8], project evaluation [9], and material selection [10], etc. Therefore, we proposed an intuitionistic fuzzy projection approach by combining linguistic variables with intuitionistic fuzzy numbers (IFNs) to analyze the performance of PDPs.

The rest of this paper is structured as follows. In Section 2, literature about the methods of project evaluation and selection are discussed. In Section 3, we introduce the notation and operation of the IFN. The proposed method is presented in Section 4. An example is implemented in Section 5 in order to illustrate the proposed method. Finally, the conclusions and future research direction are discussed in the last section.

2. LITERATURES REVIEW

Numerous MCDM methods have been presented and applied in various fields. Danneels and Kleinschmidt [11] presented a conceptual framework to identify product innovativeness. They thought that environmental familiarity, project-firm fit and technological criteria are important for evaluating product innovativeness. Based on the above criteria, experts will make a Go/No Go decision to execute project. Kumar et al. [12] demonstrated the efficacy of applying six-sigma in small medium‐sized enterprise (SME) product project selection. Weissenberger-Eibl and Teufel [13] collected past new PDP selection literatures and found that organizational politics are a critical factor that will influence project selection. Chang [14] combined a technique for order preference by similarity to the ideal solution (TOPSIS), the analytic network process (ANP), and the balanced scorecard (BSC) to analyze and evaluate new PDPs in Taiwan.

Costantino et al. [15] considered competitive environments, enterprise strategic objectives, and the project manager's experience to build project critical success factors (CSFs) and used an artificial neural network (ANN) to design a decision support system to classify successful and unsuccessful projects. Chen et al. [16] analyzed and picked new product projects according to various factors. They considered the performance of a new project and its influence on the company's past products and competitors' products to generate the maximum profit for an enterprise. Lee et al. [17] combined DEMATEL and ANP with zero-one goal programming (ZOGP) to select the optimal green aviation fleet management strategy decisions. Awasthi and Omrani [18] applied the fuzzy Delphi method to design a goal-oriented approach based on fuzzy axiomatic design to select reasonable new product projects in Luxembourg city. Peng et al. [19] applied the fuzzy TOPSIS approach to select a proper restoring technology for crankshaft remanufacturing. Wu et al. [20] integrated Dempster-Shafer theory (DST) and the analytic hierarchy process (AHP) to evaluate and rank new product projects under uncertain business environments.

Some past research has discussed new product development time. Adler et al. [21] modeled product development organization as a stochastic processing network, in which engineering resources are workstations and projects are jobs that flow between the workstations. In this model, an enterprise can predict product development times easily and reasonably because every PDP can predict its execution time in each workstation in the network. The strength of this method is that the model can predict all project development in the enterprise. The weakness of this method is that it does not consider similar projects being developed by competitors, which will influence the profit of enterprise. Carrascosa et al. [22] designed a structure matrix to estimate product development time. This method uses the probability function to predict the service time needed for each research process. The advantage of this method is that it can predict the entire product development time for both the best-case condition and the worst-case condition. Again, the disadvantage of this method is that it does not consider the developments of its competitors, who will influence the overall profit of the enterprise. Chen and Huang [23] integrated fuzzy theory and the program evaluation and review technique (PERT) to evaluate product development times. The strong point of this method is that it can cope with the product development time problem and find out the critical work stations in a project network. Decision makers can then shorten the product development time by inputting more resources to these workstations. The weakness of this method is that the predict product development time range will be large if there are many workstations in a project network. Like the above research, this method predicts product development time according to its resources and does not consider the developments of its competitors.

Internal resources and external competitors are important considerations when making project decisions. Considering internal resources, human resources [16,24], funds [25], and support of high-level manager [26] are suitable factors that have been used to select new PDP. Regarding external competitors, game theory [27] and SWOT analysis [28] are popular tools that have been applied to evaluate the performance between research enterprise and its competitors. It is therefore important to select PDPs based on internal resources and external competitors because enterprises should develop new products as fast as possible when products can be imitated easily.

From the above literatures, it can be seen that new PDP selection should consider various dimensions based on the enterprise's goals, organization policy, external environment, entire profit, product innovativeness, and competitors' behavior. The key considerations of each new product development problem are different. Most new PDP selection problems consider internal resources and external competitors simultaneously. This study analyzed and evaluated the performance of PDP in order to predict the product develop time needed for launching. Past research found that enterprises will select PDP from different versions of PDPs in the enterprise. However, every enterprise should predict its product profit according to the new product launch sequence between case enterprise and its competitors, especially for products that can be easily imitated by competitors.

3. IFN AND ITS DEFINITION

Definition 1.

Let F be a fuzzy set F=z,μFz|zZ, where Z is a universe of discourse, μF:Z0,1 is a membership function, and μFz means the membership degree of element z to Set F [29].

Definition 2.

Let Z be a fixed and nonempty set; intuitionistic fuzzy set F in Z can be described as the following equation [30]:

F=z,μFz,vFz|zZ(1)
where μF:Z0,1 is a membership function, vF:Z0,1 is a nonmembership function, and πFz=1μFzvFz is the indeterminacy degree of z in intuitionistic fuzzy set F. The membership degree and nonmembership degree are less than or equal to 1. For convenience, an intuitionistic fuzzy set F=μF,vF can be called an IFN, such that 0μF1, 0vF1, μF+vF1 and πF=1μFvF.

Definition 3.

Let a=μa,va and b=μb,vb be two IFNs, and c is a real number. We have that [7]:

  1. a+b=μa+μbμaμb,vavb.

  2. ca=11μac,vac,c>0.

Definition 4.

Let a=μa,va be an IFN; the module of IFN a is |a|=μa2+va2+πa2 [7].

Definition 5.

Let a=μa,va and b=μb,vb be two IFNs; the inner scalar product between a and b is as follows [7]:

ab=μaμb+vavb+πaπb(2)

Definition 6.

Let a=μa,va and b=μb,vb be two IFNs; the cosine of the included angle between a and b is as follows [7]:

cosa,b=ab/|a||b|(3)

Definition 7.

Let a=μa,va and b=μb,vb be two IFNs; the projection of a on b is Projba=ab|b| [7].

Definition 8.

Let A=aijmn and B=bijmn be two intuitionistic fuzzy matrices, and aij=μaij,vaij and bij=μbij,vbij. The projection of A on B is as follows [7]:

ProjBA=i=1mj=1nμaijμbij+vaijvbij+πaijπbiji=1mj=1nμbij2+vbij2+πbij20.5(4)

4. PROPOSED METHOD

4.1. Notations and Glossary

In general, the PDP problem can be formulated by the following notations:

  1. A set of expert E={E1,E2,,EK}. K represents the number of experts.

  2. A set of PDP P={P1,P2,,Pm}. m represents the number of PDPs.

  3. A set of criteria C={C1,C2,,Cn}. n represents the number of criteria.

  4. A set of weight criteria is W={w1,w2,,wn}.

  5. A decision matrix X.

X=C1C2CnP1P2Pmx˜11x˜12x˜21x˜22x˜1nx˜2nx˜m1x˜m2x˜mn(5)
where x˜ij means the linguistic performance of Pi with respect to Cj. The linguistic variable can be transformed as an IFN.

4.2. Assumptions

There are two assumptions that should be considered for evaluating the performance of PDPs of industry.

  1. Novel products that are easily copied by competitors.

    If the developed technologies of the new product cannot be imitated by other enterprises, the enterprise will monopolize the entire market, therefore this PDP should be permitted without any evaluation because it can provide long-term profit without any competition

  2. Novel products produced by each enterprise that are homogenous.

    When assessing the profit of each enterprise reasonably, it should be supposed that novel products that are developed by each enterprise are homogenous. Market share and entire profit will be equally acquired by enterprises that have developed this novel product successfully.

4.3. Process of the Proposed Method

The concept of the proposed method came from the intuitionistic fuzzy projection-based approach for partner selection [7]. At the first step, the manager should decide a PDP set. Afterward, the opinions of experts for each PDP should be collected. The experts will express their opinions about the performance of each PDP with respect to each criterion. Let x˜ijk be the linguistic opinion [16] of expert k about the performance of the i-th PDP with respect to criterion j. The linguistic opinion x˜ijk is converted into an IFN as μijk,vijk.

The experts can also describe their opinions about the importance of each criterion. Let wjk be the opinion of expert k about the importance of the j-th criterion. The integrated importance of the j-th criterion can be computed as wj=k=1Kwjk/K (K represents the number of experts).

Next, the weighted decision matrix is calculated by assigning wj to criterion Cj as [7]:

hijk=ρijk,ηijk(6)
where ρijk=11μijkwj, ηijk=vijkwj and Hi=hijknK=ρijk,ηijknK.

Once the weighted decision matrix is created, three kinds of reference points are used for evaluating the performance of PDPs. These reference points are the positive ideal decision (PID), negative ideal decision (NID), and the complement of the PID (CPID) [7].

The PID is the best and ideal result of the PDPs and is computed as:

H+=hjk+nK=ρjk+,ηjk+nK(7)
where ρjk+=maxiρijk and ηjk+=miniηijk.

The NID is the worst result of the PDPs. It is computed as:

H=hjknK=ρjk,ηjknK(8)
where ρjk=miniρijk and ηjk=maxiηijk.

The CPID is the inverse of the PID. It is computed as:

Hc=H+c=hjk+cnK=ηjk+,ρjk+nK(9)
where ηjk+=miniηijk and ρjk+=maxiρijk.

In other words, a PID represents the maximum benefit, while an NID represents the maximum loss for all PDPs.

The projection of Hi on H+projH+Hi is used to calculate the distance between Hi and H+. It can be computed as follows:

projH+Hi=j=1nk=1Kρijkρjk++ηijkηjk++πijkπjk+j=1nk=1Kρjk+2+ηjk+2+πjk+20.5(10)

The projection of Hi on HprojHHi is used to calculate the distance between Hi and H. It can be computed as follows:

projHHi=j=1nk=1Kρijkρjk+ηijkηjk+πijkπjkj=1nk=1Kρjk2+ηjk2+πjk20.5(11)

The projection of Hi on H+cprojH+cHi is used to calculate the distance between Hi and H+c. It can be computed as follows:

projH+cHi=j=1nk=1Kρijkηjk++ηijkρjk++πijkπjk+j=1nk=1Kρjk+2+ηjk+2+πjk+20.5(12)

Based on the concept of TOPSIS, the relative closeness of the i-th PDP can be computed as follows:

φi=projH+HiprojH+Hi+0.5projHHi+projH+cHi(13)

The PDPs can be ranked according to the relative closeness; the higher the value of φi, the better the project Pi.

Based on the ranking order of the PDPs, the profit index can be calculated as follows:

ψi=g=1mrankφi+11mg+1ΛgΛg1(14)
where rankφi means the rank of the i-th PDP. Λ1,Λ2,,Λm are the increasing values in accordance with the relative closeness of the PDPs (φi,i=1,2,,m), and Λ0=0.

The entire profit ratio of the i-th PDP can be calculated as follows:

Φi=ψii=1mψi(15)

5. CASE STUDY

A smartphone enterprise wants to develop new kind of smartphone in order to fit with 5th generation mobile networks (5G). In order to let the case enterprise evaluate its future product competitive ability, this enterprise compares its PDP with other PDPs developed by its competitors. At first, this enterprise invites seven experts to constitute the committee to evaluate the performance of the PDPs. The experts include high-level managers and middle-level managers in the case enterprise, high-level managers and middle-level managers in the competitive enterprises, professors of information system, industrial engineering professors, and civil servants. The experts come from the industry, government, and academia, and the opinions of the experts are representative to evaluate the performance of the PDPs.

The execution process of the proposed method is as follows:

Step 1. Decide the analysis target.

After discussion, the experts decide on five PDPs (one PDP acquired from the case enterprise and the others from its competitors) as targets from the smartphone industry for evaluating performance of the PDP in the case enterprise. The competitors have been decided mainly according to the market share of smartphones in Taiwan. The Top 5 mobile phone manufacturers in the market share are selected as competitors.

Step 2. Decide on the evaluation criteria.

The experts also decide on five criteria to evaluate the performance of the PDP. Those criteria are the patent technology needed to develop the product (C1), the talent needed to develop the product (C2), the production equipment in the enterprise (C3), the research speed needed to develop the product (C4), and the research funds needed to develop the product (C5). These criteria are suitable for evaluating the performance of the PDP if the enterprise's goal is to shorten its product develop time and launch its product as soon as possible. A number of studies have used the above criteria to make project selection (refer to Table 1).

Criterion No. Criterion Literatures
(C1) Patent technology for developing product [19,31,32]
(C2) Talent for developing product [16,24]
(C3) Production equipment in enterprise [3335]
(C4) Research speed for developing product [36,37]
(C5) Research fund for developing product [25,36,37]
Table 1

Project selection criteria.

Step 3. Collect qualitative information. (Tables A1A7 can refer to Appendix.)

The experts apply nine-scale linguistic variables to express their opinions (refer to Table A1). Each expert also expresses his/her opinion by selecting linguistic variables to describe the performance of each PDP with respect to each criterion, and the linguistic variables can collate as an IFN(refer to Table A2). Each expert expresses his/her opinion by selecting linguistic variables to describe the importance of each criterion, and the linguistic variables can collate as a score (refer to Table A3). The above experts' opinions can reflect each enterprises' resource and research ability. The enterprises' resource and research ability are transferred as the new product research time by the proposed method and used to decide the new product launch sequence of each enterprise.

Step 4. Calculate the weighted decision matrix.

This research used Equation (6) to calculate the weighted performance of each PDP with respect to each criterion (refer to Table A4).

Step 5. Calculate the values of PID, NID, and CPID, as shown in Table A5.

Step 6. Calculate the projection of the PDPs on PID, NID, and CPID, as shown in Table A6.

Step 7. Calculate the relative closeness of each PDP, as shown in Table A6.

Step 8. Calculate the profit index and entire profit ratio of each PDP, as shown in Table A6.

According to the analysis result, the rank of each PDP is P1>P2>P4>P5>P3. This rank is also the analysis result for the new product launch sequence. The PDP of case enterprise P1 is at the top of this industry and the new product launch speed is fast in this industry. However, the relative closeness of each PDP is much closer. Therefore, the product launch time point (0.539) of the case enterprise is closer to its competitors (0.538, 0.518, 0.512, and 0.500). The entire profit ratio of the case enterprise (0.215) is also closer to its competitors (0.213, 0.195, 0.191, and 0.186).

Based on the analysis result, we can find out that the new product launch time point of the case enterprise is closer to its competitor. Therefore, we can conclude that the research ability of each enterprise is the same at this time point. The case enterprise should develop or search for external resources (such as marketing channels) to increase its competitive ability if the case enterprise wants to win the battle of developing this new project.

According to the Table A6, traditional TOPSIS method will compute relative closeness just consider the projections of PID and NID. In this way, the relative closeness of the i-th PDP in accordance with traditional TOPSIS method can be computed as follows:

tφi=projH+HiprojH+Hi+projHHi(16)
where tφi is the relative closeness of the i-th PDP in accordance with traditional TOPSIS method.

The tφi of the i-th PDP is shown as Table A7. We know that the ranking order of projects is P1>P2>P4>P5P3. The ranking order of projects is similar to the proposed method. The proposed method considered three reference points such as PID, NID, and CPID can increase the reliability of ranking order than traditional TOPSIS.

6. CONCLUSIONS

Because the main goal of an enterprise is to make profit, it should select the most suitable new product project to increase its revenue and competitive advantage when competitors develop similar products in the market. In order to evaluate and select the right project to develop a new product, this paper used linguistic variables and IFNs to express the opinions of experts and reduce the fuzziness in the decision-making process. Then we proposed a new MCDM method, called the intuitionistic fuzzy projection approach, to analyze the relative position of each PDP and the ranking order of each project.

The appropriate reasons for using the proposed method to evaluate PDPs were as follows:

  1. The evaluation process is more objective

    Traditional TOPSIS can analyze PDPs according to expert opinions that are expressed by linguistic variables [38]. However, the linguistic variables handled by TOPSIS are relatively rigid and nonflexible. The proposed method transfers linguistic variables into IFNs. IFNs can provide the membership degree, nonmembership degree, and indeterminacy degree of special linguistic variables belong to one kind of status. Compared with traditional TOPSIS, the proposed method can also calculate the relative position of the PDP between the positive ideal solution and the negative ideal solution based on the projection method. However, the proposed method can deal with expert opinions more carefully, as well as PDPs with high risk and high uncertainty that require evaluating and analyzing the experts' opinions cautiously.

  2. Provide the launch sequence of each PDP

    Because some new products developed by the enterprise are similar and easily imitated, it is important to predict the new product launch sequence according to the performance of each PDP. Enterprises can analyze their profit according to the new product launch sequence. The proposed method can not only analyze and evaluate the performance of each PDP, but also predict the new product launch sequence according to the performance of each PDP. This information is important for enterprises when implementing PDP decisions.

    The traditional TOPSIS method determines the solution with the shortest distance to the ideal solution and the greatest distance from the negative-ideal solution, but it does not consider the relative importance of these distances [39]. Enterprises must consider new product launch time points when selecting PDPs to execute. Because the traditional TOPSIS method evaluates and selects PDPs based on the relative distance, it will cause projects with a high distance to the ideal solution to be judged as high-performance projects if they are also at a high distance from the negative-ideal solution. However, projects with a high distance to the ideal solution may have an increased product launch time because their strength and resources are relatively rare and relatively more time is needed to develop new products. However, projects with a high distance to the ideal solution could still be selected as high-performance projects in traditional TOPSIS. Therefore, this study did not take traditional TOPSIS as an evaluation tool.

    In the future, this method can be extended and modified by adding quantitative criteria for making decisions. At the same time, an interactive system can be presented based on the proposed method.

CONFLICTS OF INTEREST

Authors declare that no conflict of interest for publishing in this journal.

AUTHORS' CONTRIBUTIONS

Chen-Tung Chen is responsible for quality control and supervision of this paper. Wei-Zhan Hung is responsible for collecting data, computing the data and document editing of this paper.

ACKNOWLEDGMENTS

This work was supported partially by Ministry of Science and Technology, Taiwan. The project No. is “MOST 108-2410-H-239-010-MY2.”

APPENDIX

Performance
Weight
Linguistic Variable IFNs Linguistic Variable Scores
Extremely poor (EP) (0.10, 0.80) Extremely low (EL) 1.25
Very poor (VP) (0.20, 0.70) Very low (VL) 1.50
Poor (P) (0.30, 0.60) Low (L) 1.75
Medium poor (MP) (0.40, 0.50) Medium low (ML) 2.00
Fair (F) (0.50, 0.40) Fair (F) 2.25
Medium good (MG) (0.60, 0.30) Medium high (MH) 2.50
Good (G) (0.70, 0.20) High (H) 2.75
Very good (VG) (0.80, 0.10) Very high (VH) 3.00
Extremely good (EG) (0.90, 0.00) Extremely high (EH) 3.25
Table A1

Linguistic variables.

Expert 1's Opinion
Expert 2's Opinion
P1 P2 P3 P4 P5 P1 P2 P3 P4 P5
C1 VG MG P F F F EG MG VG VG
C2 G P P F MG MG F MG G MP
C3 G P MG VP VG VG VG F F G
C4 MG VP MG MG G MG VG MG G F
C5 G MG G VG VG MG F MG P VP

Expert 3's Opinion
Expert 4's Opinion
P1 P2 P3 P4 P5 P1 P2 P3 P4 P5

C1 MP G MG VP MG VG F EP MG G
C2 EG F MG MG F F VG EP MP P
C3 MG VG P EP F F VG P VG MP
C4 G F F MG MG G MG F VP F
C5 MG VP F F F VG F MG P MG

Expert 5's Opinion
Expert 6's Opinion
P1 P2 P3 P4 P5 P1 P2 P3 P4 P5

C1 F EP F VG F F EP MP EP VG
C2 EP VP MG F P VP F VP G G
C3 F P MG G G EP MG F G F
C4 F MG F MG MG EP MG MG VP G
C5 MG MP EP F G EP VG P G F

Expert 7's Opinion
P1 P2 P3 P4 P5

C1 MG G VG EP VP
C2 VP VP EP P G
C3 P VG VP G MG
C4 VG G MP VP G
C5 MG VG G MG VP
Table A2

Performances of product development projects (PDPs).

E1 E2 E3 E4 E5 E6 E7
C1 L EL EH VH F MH MH
C2 MH EL H EL H H MH
C3 MH H EL F EL MH H
C4 EL MH F H H MH F
C5 MH H EL MH F H VH
Table A3

Weight of each criterion.

Expert 1
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η
C1 0.591 0.004 0.300 0.059 0.059 0.300 0.195 0.115 0.195 0.115
C2 0.448 0.027 0.067 0.317 0.067 0.317 0.210 0.127 0.317 0.067
C3 0.460 0.030 0.073 0.329 0.329 0.073 0.030 0.460 0.615 0.007
C4 0.305 0.061 0.024 0.437 0.305 0.061 0.305 0.061 0.437 0.024
C5 0.421 0.020 0.289 0.054 0.421 0.020 0.582 0.004 0.582 0.004

Expert 2
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η

C1 0.195 0.115 0.780 0.000 0.300 0.059 0.591 0.195 0.115 0.780
C2 0.317 0.067 0.210 0.127 0.317 0.067 0.448 0.317 0.067 0.210
C3 0.615 0.007 0.615 0.007 0.221 0.136 0.221 0.615 0.007 0.615
C4 0.305 0.061 0.596 0.005 0.305 0.061 0.437 0.305 0.061 0.596
C5 0.289 0.054 0.186 0.108 0.289 0.054 0.054 0.289 0.054 0.186

Expert 3
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η

C1 0.115 0.195 0.431 0.023 0.300 0.059 0.023 0.431 0.300 0.059
C2 0.789 0.000 0.210 0.127 0.317 0.067 0.317 0.067 0.210 0.127
C3 0.329 0.073 0.615 0.007 0.073 0.329 0.007 0.615 0.221 0.136
C4 0.437 0.024 0.200 0.119 0.200 0.119 0.305 0.061 0.305 0.061
C5 0.289 0.054 0.020 0.421 0.186 0.108 0.186 0.108 0.186 0.108

Expert 4
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η

C1 0.591 0.004 0.195 0.115 0.004 0.591 0.300 0.059 0.431 0.023
C2 0.210 0.127 0.605 0.006 0.006 0.605 0.127 0.210 0.067 0.317
C3 0.221 0.136 0.615 0.007 0.073 0.329 0.615 0.007 0.136 0.221
C4 0.437 0.024 0.305 0.061 0.200 0.119 0.024 0.437 0.200 0.119
C5 0.582 0.004 0.186 0.108 0.289 0.054 0.054 0.289 0.289 0.054

Expert 5
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η

C1 0.195 0.115 0.004 0.591 0.195 0.115 0.591 0.004 0.195 0.115
C2 0.006 0.605 0.027 0.448 0.317 0.067 0.210 0.127 0.067 0.317
C3 0.221 0.136 0.073 0.329 0.329 0.073 0.460 0.030 0.460 0.030
C4 0.200 0.119 0.305 0.061 0.200 0.119 0.305 0.061 0.305 0.061
C5 0.289 0.054 0.108 0.186 0.004 0.582 0.186 0.108 0.421 0.020

Expert 6
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η

C1 0.195 0.115 0.004 0.591 0.115 0.195 0.004 0.591 0.591 0.004
C2 0.027 0.448 0.210 0.127 0.027 0.448 0.448 0.027 0.448 0.027
C3 0.007 0.615 0.329 0.073 0.221 0.136 0.460 0.030 0.221 0.136
C4 0.005 0.596 0.305 0.061 0.305 0.061 0.024 0.437 0.437 0.024
C5 0.004 0.582 0.582 0.004 0.054 0.289 0.421 0.020 0.186 0.108

Expert 7
P1
P2
P3
P4
P5
ρ η ρ η ρ η ρ η ρ η

C1 0.300 0.059 0.431 0.023 0.591 0.004 0.004 0.591 0.023 0.431
C2 0.027 0.448 0.027 0.448 0.006 0.605 0.067 0.317 0.448 0.027
C3 0.073 0.329 0.615 0.007 0.030 0.460 0.460 0.030 0.329 0.073
C4 0.596 0.005 0.437 0.024 0.119 0.200 0.024 0.437 0.437 0.024
C5 0.289 0.054 0.582 0.004 0.421 0.020 0.289 0.054 0.020 0.421
Table A4

Weighted decision matrix of each expert.

PID
C1 C2 C3 C4 C5
E1 ρ 0.591 0.448 0.615 0.437 0.582
η 0.004 0.027 0.007 0.024 0.004
E2 ρ 0.780 0.448 0.615 0.596 0.289
η 0.000 0.027 0.007 0.005 0.054
E3 ρ 0.431 0.789 0.615 0.437 0.289
η 0.023 0.000 0.007 0.024 0.054
E4 ρ 0.591 0.605 0.615 0.437 0.582
η 0.004 0.006 0.007 0.024 0.004
E5 ρ 0.591 0.317 0.460 0.305 0.421
η 0.004 0.067 0.030 0.061 0.020
E6 ρ 0.591 0.448 0.460 0.437 0.582
η 0.004 0.027 0.030 0.024 0.004
E7 ρ 0.591 0.448 0.615 0.596 0.582
η 0.004 0.027 0.007 0.005 0.004

NID
C1 C2 C3 C4 C5

E1 ρ 0.300 0.317 0.460 0.437 0.054
η 0.059 0.067 0.030 0.024 0.289
E2 ρ 0.115 0.210 0.136 0.119 0.421
η 0.195 0.127 0.221 0.200 0.020
E3 ρ 0.431 0.127 0.615 0.119 0.421
η 0.023 0.210 0.007 0.200 0.020
E4 ρ 0.591 0.605 0.329 0.437 0.289
η 0.004 0.006 0.073 0.024 0.054
E5 ρ 0.591 0.605 0.329 0.119 0.582
η 0.004 0.006 0.073 0.200 0.004
E6 ρ 0.591 0.448 0.615 0.596 0.582
η 0.004 0.027 0.007 0.005 0.004
E7 ρ 0.591 0.605 0.460 0.437 0.421
η 0.004 0.006 0.030 0.024 0.020

CPID
C1 C2 C3 C4 C5

E1 ρ 0.004 0.027 0.007 0.024 0.004
η 0.591 0.448 0.615 0.437 0.582
E2 ρ 0.000 0.027 0.007 0.005 0.054
η 0.780 0.448 0.615 0.596 0.289
E3 ρ 0.023 0.000 0.007 0.024 0.054
η 0.431 0.789 0.615 0.437 0.289
E4 ρ 0.004 0.006 0.007 0.024 0.004
η 0.591 0.605 0.615 0.437 0.582
E5 ρ 0.004 0.067 0.030 0.061 0.020
η 0.591 0.317 0.460 0.305 0.421
E6 ρ 0.004 0.027 0.030 0.024 0.004
η 0.591 0.448 0.460 0.437 0.582
E7 ρ 0.004 0.027 0.007 0.005 0.004
η 0.591 0.448 0.615 0.596 0.582
Table A5

PID), negative ideal decision (NID), and complement of the positive ideal decision (CPID).

P1 P2 P3 P4 P5
Projection of PID 3.513 3.579 3.205 3.242 3.397
Projection of NID 3.341 3.433 3.380 3.156 3.585
Projection of CPID 2.657 2.718 3.022 2.872 2.897
Relative closeness 0.539 0.538 0.500 0.518 0.512
PDP profit index 0.116 0.115 0.100 0.105 0.103
Entire profit ratio 0.215 0.213 0.186 0.195 0.191
Rank 1 2 5 3 4
Table A6

Information of each product development project (PDP).

P1 P2 P3 P4 P5
Projection of PID 3.513 3.579 3.205 3.242 3.397
Projection of NID 3.341 3.433 3.380 3.156 3.585
Relative closeness 0.513 0.510 0.487 0.507 0.487
Rank 1 2 4 3 4
Table A7

Rank of each product development project (PDP) by traditional technique for order preference by similarity to the ideal solution (TOPSIS).

REFERENCES

3.S. Klepper, Entry, exit, growth, and innovation over the product life cycle, Am. Econ. Rev., Vol. 86, 1996, pp. 562-583. https://www.jstor.org/stable/2118212
Journal
International Journal of Computational Intelligence Systems
Volume-Issue
14 - 1
Pages
935 - 945
Publication Date
2021/03/03
ISSN (Online)
1875-6883
ISSN (Print)
1875-6891
DOI
10.2991/ijcis.d.210222.003How to use a DOI?
Copyright
© 2021 The Authors. Published by Atlantis Press B.V.
Open Access
This is an open access article distributed under the CC BY-NC 4.0 license (http://creativecommons.org/licenses/by-nc/4.0/).

Cite this article

TY  - JOUR
AU  - Chen-Tung Chen
AU  - Wei-Zhan Hung
PY  - 2021
DA  - 2021/03/03
TI  - A MCDM Method with Linguistic Variables and Intuitionistic Fuzzy Numbers to Evaluate Product Development Projects
JO  - International Journal of Computational Intelligence Systems
SP  - 935
EP  - 945
VL  - 14
IS  - 1
SN  - 1875-6883
UR  - https://doi.org/10.2991/ijcis.d.210222.003
DO  - 10.2991/ijcis.d.210222.003
ID  - Chen2021
ER  -
